Indonesia Staff Accommodation

Location: Indonesia
Building Type: Staff Accommodation
Module Type: Steel Volumetric System
Construction type: New Construction
Finished in: 2026
Area: 8,410㎡
Floors: 6
Modules: 246
Rooms/Keys: 226
Work scope: Design + Module Supply + Transportation + On-site Installation

In some industrial parks across Southeast Asia, project delivery can be affected by a range of uncertainties, including shortages of skilled construction workers, restrictions on cross-border workforce deployment, frequent disruption during the rainy season, and long procurement lead times for imported building materials, which can extend to five or six months. Labour availability, weather conditions and supply chain constraints can therefore all pose significant risks to construction schedules.

To address these challenges, CIMC Modular Building Systems adopts an integrated “design + manufacturing + service” model, shifting more than 90% of construction activities to factories in China. Through centralized procurement, standardized production and large-scale prefabrication, the approach reduces dependence on overseas site labour and local material supply. The completed modules are then transported across borders and rapidly installed on site to complete project delivery.

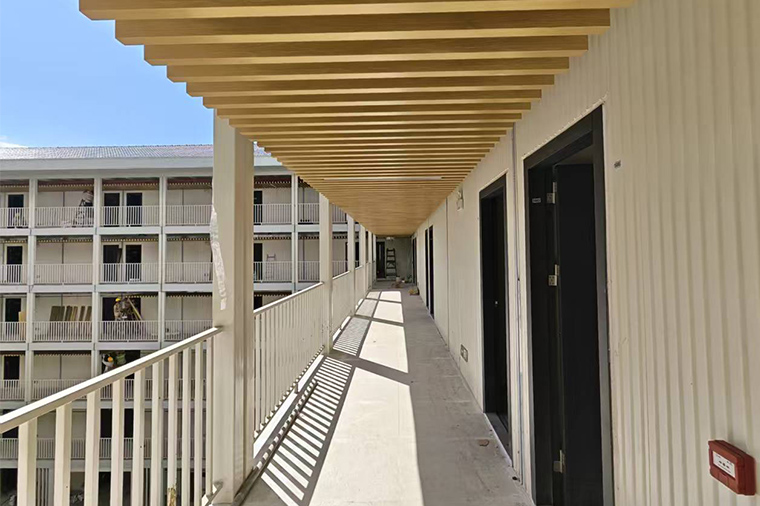

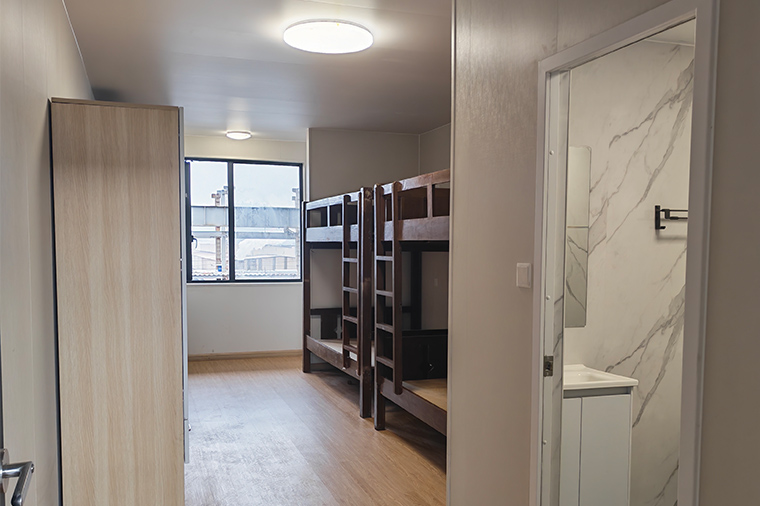

For the employee accommodation project in Indonesia, the design was specifically adapted to the country’s hot, humid and rainy climate. Particular attention was given to critical areas such as structural corrosion protection and roof waterproofing, helping enhance the building’s long-term durability and reliability.

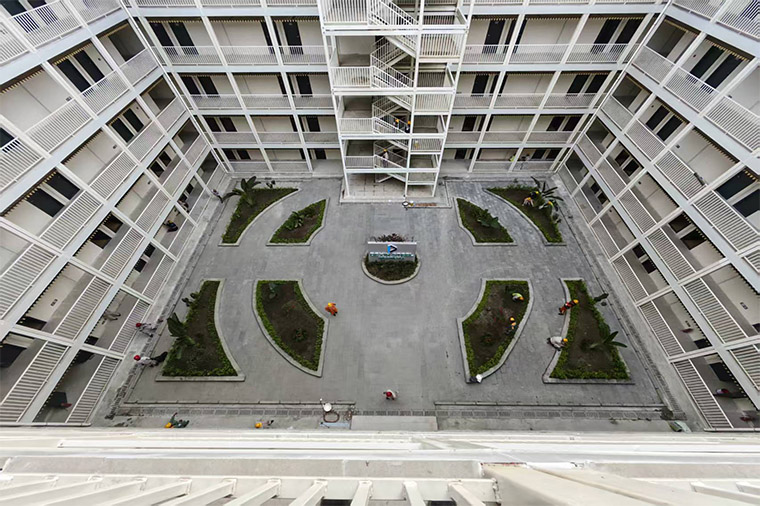

From module production and transportation to on-site installation and completion of supporting works, the entire project was delivered in approximately seven months—two months ahead of the original schedule. Compared with the typical construction period of 1.5 to 2 years for projects of a similar scale in the local market, modular construction demonstrated clear advantages in both delivery efficiency and schedule predictability.

The value of this model goes beyond simply “building faster.” By converting a greater proportion of unpredictable overseas site work into controlled industrialized production, it provides customers with greater certainty over project delivery. The project owner expressed strong satisfaction with the final outcome.

Discuss A Quote

Talk to Us Today

Building Location*
c
Building Type*
Scale*
Project Category*
Duration*
Is this property already entitled/approved?
Have you secured funding for your development?
Special Requirements
Name*
Email*
Company*
Business Role*
Submit
Get A Brochure
Instant access to full details of products, solutions,
and highlights – delivered to your inbox.
Name*
Company*
Email*
Position*
Country/Region*
Submit
